Sanibel Arms Reconstruction
Restoring the Heart of Sanibel Island Stronger, Safer, Sustainable.
Update Tracker
Update Date | Title | Description |
|---|---|---|
11/25/2025 | Building E – Units E1–E4 | Electrical, plumbing, drywall, flooring complete; bathrooms partially complete. |
11/25/2025 | Building E – Exterior | Meter panels and roof repairs complete; exterior paint partially complete. |
11/25/2025 | Building E – Units E5–E8 | Electrical upgrades and HVAC complete; tankless water heaters partially installed. |

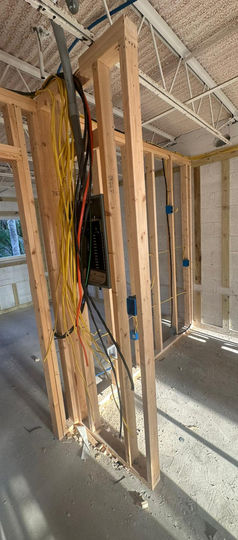

11/25/2025 | Building G – Units G1–G4 | Framing, electrical, plumbing, HVAC complete. |
11/25/2025 | Building D – Units D1–D4 | Electrical, plumbing, drywall, flooring complete; bathrooms partially complete. |
11/25/2025 | Building H – Units H1–H4 | Electrical, plumbing, drywall, flooring complete; bathrooms partially complete. |
11/25/2025 | Building A – Units A5–A8 | Electrical upgrades and HVAC complete; drywall partially complete. |
11/25/2025 | Building C – Units C5–C8 | Electrical and HVAC complete; drywall partially complete; tankless water heaters partially installed. |
11/25/2025 | Building H – Exterior | Meter panels and roof repairs complete |
11/25/2025 | Building G – Exterior | Roof coating, balconies, slabs, staircases complete; exterior paint remains in progress. |
11/25/2025 | Building H – Units H5–H8 | Electrical upgrades, impact windows, HVAC complete. |
11/25/2025 | Building F – Units F1–F4 | Framing, electrical, plumbing, HVAC complete. |
11/25/2025 | Building C – Units C1–C4 | Electrical, plumbing, drywall, flooring complete |

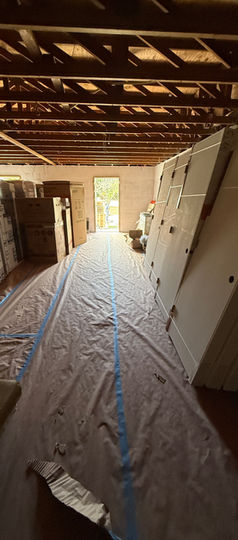

11/08/2025 | Clubhouse | Flooring partially complete; framing continues in common area. |
11/08/2025 | Bathrooms | Complete in A; partial completion in B and C with remaining units outstanding. |
11/08/2025 | Water Heaters | Installed in select units A–G; partial installations remain in E, F, G; H in progress. |
11/25/2025 | Clubhouse – Exterior | Meter panels, HVAC units, and exterior primer paint complete. |
11/25/2025 | Clubhouse – Interior | Flooring fully installed and complete on storage side. |
11/25/2025 | Landscaping & Grounds | Materials ordered; debris removal and lawn maintenance ongoing. |

11/25/2025 | Boardwalk | Boardwalk framed; construction in progress. |

11/25/2025 | Pool | Pool resurfaced with plumbing complete; new pump and filter installed. |
11/25/2025 | Electrical & Utilities | Underground electrical complete property wide; LCEC conduits and transformers installed. |
11/25/2025 | Building G – Units G5–G8 | Demolition, framing, MEP, insulation, and turtle glass impact windows installed. |
11/25/2025 | Building F – Exterior | Meter panels, balconies, second-floor slabs, staircases, and fire extinguishers complete. |
11/25/2025 | Building F – Units F5–F8 | Demolition, framing, MEP, insulation, and turtle glass impact windows installed. |
11/25/2025 | Building D – Exterior | Meter panels, exterior paint, roof repairs, and roof coating complete. |
11/25/2025 | Building D – Units D5–D8 | Electrical upgrades, impact windows, HVAC, tankless water heaters, drywall repairs complete. |
11/25/2025 | Building C – Exterior | Meter panels, exterior paint, roof repairs and coating, fascia, gutters, soffit complete. |
11/25/2025 | Building B – Exterior | Meter panels, exterior paint, roof repairs and coating, fascia, gutters, soffit complete. |
11/25/2025 | Building B – Units B5–B8 | Electrical upgrades, impact windows, HVAC, tankless water heaters, drywall repairs, and finishes complete. |
11/25/2025 | Building B – Units B1–B4 | All interior work complete including kitchens, bathrooms, flooring, finishes, HVAC, and tankless water heaters. |
11/25/2025 | Building A – Exterior | Meter panels, exterior paint, roof repairs and coating, fascia, gutters, soffit complete. |
11/25/2025 | Building A – Units A1–A4 | All interior work complete including kitchens, bathrooms, flooring, finishes, HVAC, and tankless water heaters. |
11/08/2025 | Plumbing & Electrical Rough-In | Complete in F, G upper and lower. |
11/08/2025 | Framing | Complete in F, G lower; upper repairs ongoing. |
11/08/2025 | Landscaping | Materials delivered for A, B, C. |
11/08/2025 | Windows & Doors | Lower units complete; upper units ongoing A–H. |
11/08/2025 | HVAC | All rooftop and interior units installed. |
11/08/2025 | Appliances | Installed in A, B; ordered for C–H. |
11/08/2025 | Kitchens | Cabinets and countertops done in A, B; C ongoing. |
11/08/2025 | Flooring | Complete in A, B, C; D, E next week. |
11/08/2025 | Painting | Exterior paint in progress on D, E, F. |
11/08/2025 | Stucco | Major stucco complete; minor repairs in progress. |
11/08/2025 | Electrical | All wiring and panels complete; clubhouse wiring ongoing. |
10/30/2025 | Windows | Slider Replacement has been completed in H8 |
10/30/2025 | Windows | Replacement has been completed in H7 |
10/27/2025 | Windows | Installation has begun in Building H |
10/27/2025 | Windows | Installation is complete in Buildings A, B, and C |
10/27/2025 | Sliding Doors | Installation has begun in Buildings A, B, and C |
10/22/2025 | Windows | 2nd Floor Windows are Being Replaced for Impact Windows in all Buildings |
10/22/2025 | Exterior Panel | Has been installed on the Clubhouse |
10/22/2025 | Bathrooms | Toilets and vanities are currently being installed in Buildings A & B |
10/13/2025 | Windows | Installation beginning in Buildings A, B, & C |
10/13/2025 | Electrical | Installation Beginning in the Clubhouse Area |
10/13/2025 | Drywall | Installation Beginning in the Clubhouse Area |
10/13/2025 | Flooring | 1/2 Completed in the Clubhouse Area |
10/13/2025 | Framing | Underway in the Clubhouse Area |
10/13/2025 | Exterior Pannels | Fully Installed and Ready for Inspection |
09/29/2025 | Storm Doors | Installation for Buildings A, B, & C to begin today. |
09/29/2025 | Windows | Installation for Buildings A, B, & C to begin today. |
09/22/2025 | Windows | Ordered and set to be delivered in two weeks for Buildings A, B, & C |
09/22/2025 | Clubhouse Flooring | Underway in the storage side of building |
09/22/2025 | Bathrooms | Fully completed in Buildings A & B |
09/22/2025 | Flooring | Fully installed in Buildings A & B |
09/22/2025 | Doors & Trim | Fully installed in Buildings A & B |
09/22/2025 | Kitchen Cabinets | Fully installed in Buildings A & B |
09/22/2025 | Kitchen Countertops | Fully installed in Buildings A & B |
09/15/2025 | Kitchen Appliances | Currently being installed in Building A |
09/15/2025 | Kitchen Countertops | Currently being installed in Building A |
09/10/2025 | Exterior Painting | Underway at Buildings E & F |
09/10/2025 | Breaker Pannel Installation | Fully completed property wide besides Clubhouse |
09/10/2025 | AC Installation | Fully completed property wide besides Clubhouse |
09/10/2025 | Appliances | Have all been ordered for Buildings A & B |
09/10/2025 | Countertops | Currently being installed in Buildings A & B |
09/10/2025 | Trim | Currently being installed in Buildings A & B |
09/10/2025 | Doors | Currently being installed in Buildings A & B |
09/10/2025 | Kitchen Cabinets | Currently being installed in Buildings A & B |
09/10/2025 | Bathrooms | Currently being installed in Building A |
09/10/2025 | Flooring | Currently being installed in Building A |
08/25/2025 | Ceiling Framing | Commenced in Buildings F & G today |
08/25/2025 | Interior AC Installation | Still ongoing, will be completed in a week |
08/25/2025 | Exterior Painting | Buildings D&E have begun being painted |
08/18/2025 | AC Delivery | Fully delivered throughout all buildings |
08/18/2025 | Tankless Water Heaters | Fully delivered throughout all buildings |
08/18/2025 | Electrical Panels | Fully completed throughout all buildings |
08/18/2025 | Electrical Rough-Ins | Completed in all buildings except Building H |
08/12/2025 | AC Units | Buildings A,B,&C have each received the delivery of the AC units |
08/12/2025 | Stucco | All Stucco work has been completed site wide outside of minor patches |
08/12/2025 | Exterior Lighting | Initial surveying all day |
08/05/2025 | AC Installation | New AC units installed in top floor units of Buildings A and C. Building B has installed AC units on both floors. |
08/05/2025 | Underground Electrical Wiring | Fully completed across the property. |
08/05/2025 | Interior Electrical Panels 1/2 | Installed in Buildings A, B, C, D, F, and G |
